Windspray Colorbond Shed Guide with Installation and Costs

windspray colorbond shed — by the end of this hands-on guide you will know which Windspray Colorbond shed variant fits your site and budget, how to prepare a foundation, step through a full installation, and control insulation and condensation for Melbourne’s climate. Expect to allocate 2–3 weekends for a skilled DIYer or 1–3 weeks for a licensed contractor; skill level assumed: intermediate DIY (carpentry, power tools, basic concreting).

Introduction to Windspray Colorbond Sheds

Windspray Colorbond shed describes a family of pre-engineered metal sheds built using Colorbond® steel panels in a Windspray profile: modern roof and wall geometry, pre-punched fixing points, and integrated flashings designed for Australian backyards. Colorbond (a pre-painted steel product) is engineered for corrosion protection and thermal performance compared with untreated metal.

These sheds are aimed at homeowners and small businesses in Melbourne who want a durable, low-maintenance structure for storage, workshop or hobby spaces. Typical uses include tool storage, garden equipment, small woodworking shops, ride-on mower garages, and covered firewood stores.

Why Windspray for Melbourne? The design is tuned to shed rain effectively, resist moderate coastal salt exposure with appropriate Colorbond grades, and provide clean lines for suburban regulations. This guide focuses on real-world decisions: site prep, council permit triggers, foundation choices for Melbourne soils, and condensation control during humid summers and cool winters.

Transition: Next we’ll break down the specific features and benefits that make Windspray Colorbond sheds a top choice in Australian suburbs.

Features and Benefits of Windspray Colorbond Sheds

The Windspray shed blends structural efficiency with the corrosion and finish benefits of Colorbond steel. Below are the key features and why they matter in Melbourne.

  • Rust resistance and corrosion protection — Colorbond’s pre-painted zinc/aluminium alloy coating plus polymer topcoat significantly delays corrosion when compared to bare galvanised steel. As per recent Colorbond technical manuals, correct flashing and edge protection are essential in coastal zones.
  • Thermal performance — Colorbond panels reflect solar heat better than unpainted steel; combined with insulation, they reduce internal peak temperatures. According to a 2022 thermal performance analysis, insulated Colorbond sheds can reduce peak internal temps by 6–12°C versus uninsulated.
  • Low maintenance — pre-finished panels remove the need for routine repainting; simple hosing and gutter clearing keep the shed in service for decades.
  • Color and aesthetic options — Colorbond offers a palette tuned for Australian homes (Surfmist, Cottage Green, Monument). Matching roof and trim gives a suburban-friendly finish that often helps planning approval.
  • Structural integrity — Windspray profiles include braced frames and purlin systems sized for typical wind loads; engineered kits include certified fixings for Australian wind classifications.
  • Versatility — modular panels and configurable floorplans make Windspray suitable for garages, workshops, garden sheds and micro-commercial uses.
  • Warranty and technical support — as per Colorbond manufacturer documents, registered installations have backed warranties for paint and substrate—confirm the model and warranty period before purchase.

Comparison context: For readers evaluating alternatives, see the corrugated iron shed essentials guide to contrast materials and profiles. Also consider garden-focused options in the garden shed greenhouse guide for plant-friendly designs.

Transition: With features understood, choose the right size and configuration—next section helps map workflows to floorplans.

Windspray Colorbond Shed Sizes and Configurations

Windspray kits come in standard modules and fully custom options. Below is a practical comparison of common configurations used in Melbourne suburbs with footprint, typical use and clearance notes.

Model / Footprint Typical use Key dimensions Notes
Small (2.4m x 3.0m) Garden tools, mower storage Roof clearance ~2.1–2.4m No permit in many Melbourne zones if under 10m² and <2.4m height—check council rules.
Medium (3.6m x 6.0m) Workshop, small garage Clear internal width 3.4m; roller door options Common for hobby workshops; concrete slab recommended.
Large (6.0m x 9.0m) Double garage, commercial storage High clearance, heavy-duty frames Usually requires engineering and council approval in residential areas.
Custom configurations Split-plan workshops, mezzanine storage Tailored to site constraints Custom orders increase lead times and cost; allow 4–8 weeks.

Brief explanations:

  • Standard sizes are quickest to supply and fit typical council exemptions for small sheds; use standard footprints if you need a fast build and lower cost.
  • Custom options allow additional doors, windows, and internal partitions—factor in structural bracing for larger spans.
  • Garage vs garden shed — garage-style Windspray kits use higher-rated purlins and larger door openings; garden sheds use lighter framing and smaller doors to save cost.

Specialised uses: If your priority is firewood storage, see the firewood shed design and construction guide. For maximizing usable insulated space, review the shed cabin planning guide with storage and insulation tips.

Transition: With size chosen, the next section walks you through a step-by-step installation so you can either plan DIY days or brief your contractor precisely.

Installation Guide for Windspray Colorbond Sheds

This section is a detailed, practitioner-level installation walkthrough covering foundation selection, fixing, roof ventilation, and Melbourne-specific permit considerations. Follow numbered steps; each step opens with a bold action instruction.

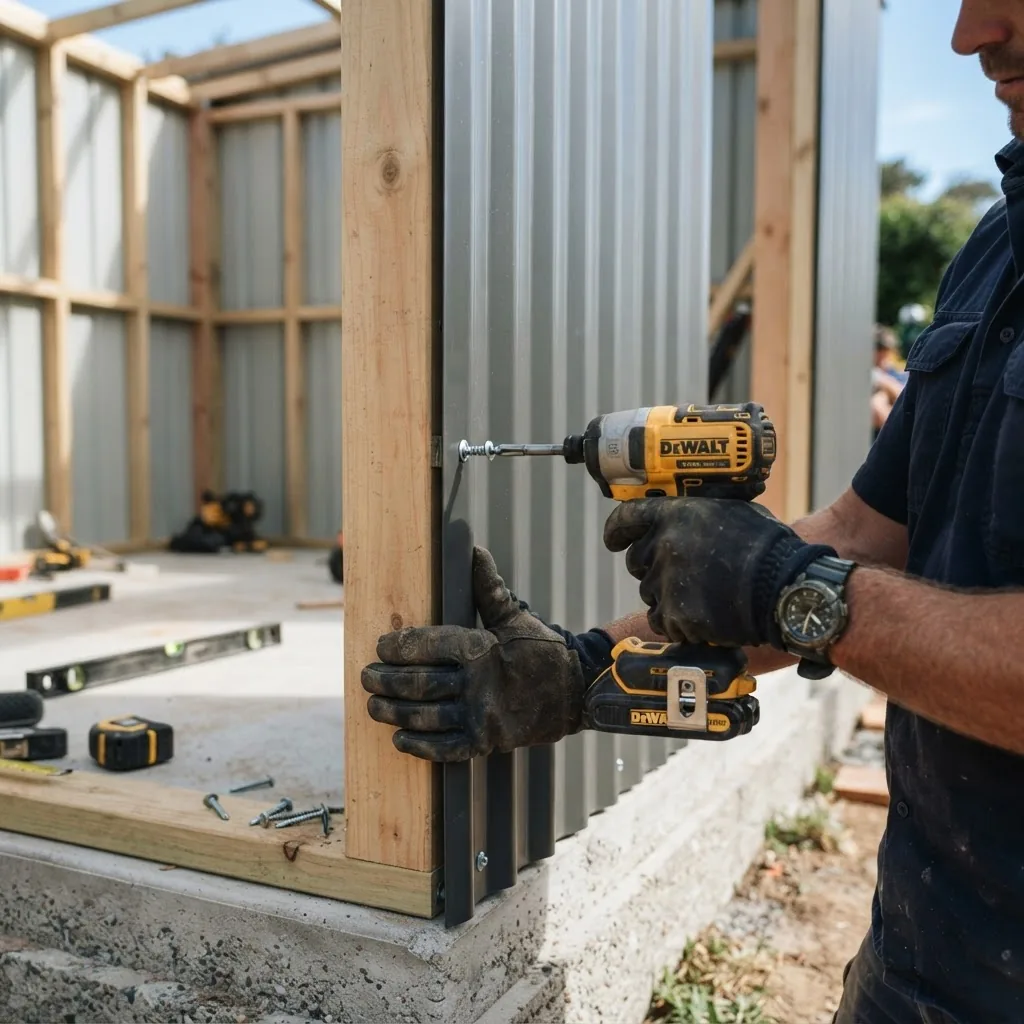

A close-up photo of a tradesman’s hands securing Colorbond shed wall panels with power tools on a foundation, outdoors on a sunny day,

Before you start the steps below, note: According to 2024 Victorian building regulations, any structure over certain sizes or with plumbing/electrical work requires a building permit—see local council planning advice and the Victorian Building Authority for thresholds. External guidance: Victorian Building Authority and the Australian Building Code resource at abcb.gov.au.

Before you start

  • Permits & site checks: confirm property title setbacks, easements, and council permit triggers with your local council (allow 2–6 weeks for approvals).
  • Tools: circular saw with metal blade, impact driver, 10mm/13mm sockets, spirit level, laser level, caulking gun, concrete mixer or pre-mix delivery.
  • Materials: Windspray kit (panels, flashings, fixings), 20–40 MPa concrete for slab/footings, DPC membrane, galvanised anchor bolts, condensation control products, insulation if chosen.
  • Personal protective equipment: gloves, eye protection, hearing protection, dust mask.
  • Helpers: two competent adults recommended for sheet handling; heavy lifts require mechanical assistance.
  1. Confirm site location and services

    1. Mark the proposed shed footprint with pegs and string; measure diagonals to confirm squareness within 10mm over the footprint.
    2. Call Dial Before You Dig (1100 Australia equivalent) to locate underground services—allow 3–5 business days for markings.
    3. Verify stormwater flow—do not place slab where stormwater will pond; slope site 1:100 away from the shed.
  2. Decide foundation type and set levels

    1. For small-to-medium Windspray sheds on stable Melbourne suburban soils, a 100–150mm reinforced concrete slab (20–40 MPa) with 75mm aggregate underlay is recommended; larger sheds need 150–200mm slabs with mesh or fibre reinforcement.
    2. Alternative: a reinforced concrete perimeter footing with compacted crushed rock (100mm) and timber floor or shed base for uneven sites—this reduces concrete cost for workshops with lightweight loads.
    3. Set finished floor level 50–100mm above adjacent ground to avoid surface runoff ingress in heavy rain.
  3. Prepare and pour concrete foundation

    1. Excavate to required depth; compact subgrade to at least 95% standard proctor density.
    2. Install formwork with level tops within ±5mm over each 3m run; place steel mesh (A142 or as specified) centrally in slab thickness.
    3. Use a slump of 80–120mm for slab pours. For DIY with pre-mix, schedule delivery for same-day pour. Trowel finish to flatness within 5mm over 2m for smooth door operation.
    4. Cure concrete for at least 7 days before fixing baseplates—use wet curing or curing membrane to prevent rapid moisture loss.
  4. Install DPC and anchor bolts

    1. Lay a 200mm wide DPC (damp-proof course) strip under the base channel to isolated moisture.
    2. Position and set galvanised anchor bolts (M12 or M16 typical) in wet concrete to match the Windspray base channel bolt holes; tolerance ±10mm. Use steel templates to ensure pattern accuracy.
  5. Assemble base channel and frame

    1. Fix base channel to anchor bolts using spring washers and nuts torqued to manufacturer torque spec (typically 30–40Nm for M12). Verify level and squareness before final torque.
    2. Assemble wall frames and corner posts on the base channel—use factory-drilled holes and supplied bolts; tighten progressively, checking plumb and square at each corner. Keep a 2–4mm clearance where required for thermal movement.
  6. Install roof purlins, rafters and bracing

    1. Assemble roof purlins per Wind classification; use spacings from manufacturer—commonly 900–1200mm centres for light-duty and 600–900mm for higher wind zones.
    2. Install cross bracing as supplied and torque all roof connections. Check for lateral movement and reinforce as needed.
    3. Before roofing sheets, plan for roof ventilation—refer to the roof ventilation installation guide for detailed flume and vent placements.
  7. Fix Colorbond wall and roof panels

    1. Start at a corner; align the first sheet and secure through the ribs at specified distances (often 450–600mm spacing for walls, 300–450mm for roofing). Use the recommended self-drilling screws with EPDM washers supplied with the kit.
    2. Overlap sheets per manufacturer’s instructions, typically 150mm for walls and 200–300mm for roofs. Seal end laps with silicone sealant where directed for watertightness.
    3. Trim panels with an approved nibbing tool or metal-cutting blade; avoid grinding which damages factory coatings.
  8. Install flashings, gutters and downpipes

    1. Fit eave flashings and ridge capping per kit sequence; fasten with recommended fixings and seal with neutral-cure silicone at overlaps.
    2. Install gutters sized for local rainfall intensity—Melbourne’s heavier storm events require minimum Commercial 100mm half-round or 120mm box gutters depending on roof area.
    3. Connect downpipes to stormwater or soakage per council guidance; avoid dumping water onto neighbouring properties.
  9. Install doors, windows and accessories

    1. Fit roller or hinged doors on prepared openings; ensure smooth operation and correct jamb sealing to prevent water ingress.
    2. Install security features (deadlocks, padlocks) and ventilation accessories (louvres, whirlybirds) as per planned use.
  10. Final checks and commissioning

    1. Do a full water test if possible—hose the roof and check internal joints and doors for leaks. Address any weep points immediately.
    2. Apply touch-up paint to any exposed cut edges per Colorbond technical manual recommendations.
    3. Register warranty with your supplier and retain the kit serial numbers and installation photos for future claims.

Common mistakes and how to avoid them

I once saw a shed fixed directly to soft subgrade without proper compaction; within two seasons the doors warped and water pooled. Always compact subgrade to 95% density and use a reinforced slab. Another common failure is under-anchoring the base channel—use the bolt pattern template and torque to spec to avoid wind uplift failures.

Checklist to verify installation

  • Base slab level within ±5mm per 3m run and edges cured 7+ days.
  • Anchor bolts set to pattern, base channel torque checked.
  • Frame plumb within 5mm over 2.4m height.
  • Roof purlins and bracing installed to manufacturer spacing and torque settings.
  • Colorbond sheets fixed at recommended screw spacing and sealed at laps.
  • Gutters sized, downpipes connected, and water test completed.
  • Warranty registered and photos saved (plate numbers, batch codes).

When to call in a professional

Engage a licensed builder or structural engineer if your shed exceeds 20m², includes live electrical/plumbing, is sited in a high-wind coastal zone, or if the site has unstable soils—these conditions commonly trigger building permits under Victorian rules. For council submission assistance, a professional can provide engineered drawings and BASIX-type documentation when required.

Transition: Now that the build steps are clear, let’s break down the costs you should expect in Melbourne.

Cost Breakdown of Windspray Colorbond Sheds in Melbourne

Costs vary by size, complexity, site access and council permit requirements. Below is a practical breakdown of cost drivers with typical Melbourne ranges (2025 market snapshot), plus a compact estimate table.

shows a segmented pie chart with percentage breakdown of total Windspray Colorbond shed costs: materials, labour, permits, delivery, and

Cost factors (explanations):

  • Materials — Colorbond panels, structural steel, flashings and fixings. Expect materials to account for 40–55% of total cost. According to a 2024 industry report, Colorbond price fluctuations can add 5–10% annually to raw material cost.
  • Labour — Trades rates in Melbourne typically range from $65–$120 per hour depending on skill; a 3.6×6.0 medium shed install by a two-person team often totals $1,800–$3,500 in labour.
  • Permits and engineering — Council building permits in Melbourne can cost $300–$2,000 depending on value and whether a certificate of compliance is required; engineering or design for larger sheds may add $500–$2,500.
  • Delivery and access — Delivery for kits within Melbourne metro often $150–$400; tight access sites requiring crane or additional handling may add $500–$2,000.
  • Extras — Insulation, flooring, gutter upgrades, extra doors/windows, electrics and lighting; budget 10–30% of base build cost for fitout.
Size Materials (approx) Labour & install Total estimate (Melbourne)
Small 2.4×3.0m $900–$1,600 $600–$1,400 $1,800–$3,500
Medium 3.6×6.0m $2,200–$4,200 $1,800–$3,800 $4,500–$10,500
Large 6.0×9.0m $6,000–$11,000 $4,000–$10,000 $12,000–$30,000+

Budget tips:

  • Choose a standard size kit to reduce lead-time and cost.
  • Do the slab work yourself if competent—concrete accounts for a significant portion of labour cost (expect $600–$2,500 saved per slab depending on size).
  • Bundle extras (doors, gutters) in the original supplier quote to lower combined delivery fees.
  • For alternative lightweight options, review the awning shed buying guide which outlines lower-cost canopy-style solutions.

Limitations and disclaimers: Costs vary across Melbourne; labour rates are indicative. Always obtain three written quotes and request itemised estimates. According to a 2024 Victorian building regulations summary, permit fees and thresholds remain subject to council discretion; factor potential permit cost into your budget.

Transition: Material and installation cost choices influence insulation and condensation behaviour—next we tackle practical strategies for Melbourne’s climate.

Insulation and Condensation Control for Windspray Colorbond Sheds

Condensation is the process where warm moist air contacts a cooler surface and deposits water. In a windspray shed with metal panels, condensation forms on the underside of roof and wall panels unless managed. Melbourne’s humid summer mornings and cool nights create repeated cycles that encourage condensation without adequate control.

Primary strategies:

  • Continuous roof and wall insulation — use closed-cell foil-backed insulation (e.g., PIR panels or foil-faced PIR) fixed under the roof sheeting or behind wall sheets. These reduce heat transfer and provide a condensation break; PIR panels commonly come in 50–75mm thickness providing R-values of R1.7–R2.5 per 50mm layer.
  • Breathable membrane plus insulation — a breathable sarking under the roof allows trapped moisture to escape while limiting wind-driven rain ingress. Install sarking on purlins before roof sheets, then add insulation as interior lining.
  • Ventilation — control internal humidity using passive vents and ridge ventilation; mechanical extraction (small bathroom-style fans) can be used in workshops with high moisture load. For detailed vent selection refer to the best roof vents guide and the roof air vents and shed ventilation systems buying guide.
  • Thermal break at fixings — avoid direct metal-to-metal thermal bridges where possible; use insulated washers and fixings specified by the manufacturer.
  • Internal linings — install 9–12mm plasterboard or fibre cement over insulation when you need conditioned internal spaces; this adds thermal mass and a finished interior surface.

For granular product guidance and panel installation techniques, see our pillar resource: Shed Insulation Guide with Panels and Wall Insulation Tips.

Practical step-by-step condensation control (installation sequence):

  1. Control moisture sources first — locate washing, drying or plant-growing activities away from the shed or remove these sources; use external sheds for firewood and wet materials.
  2. Install a breathable sarking under the roof — fix to purlins before roof sheets to allow moisture diffusion outwards; follow manufacturer’s overlap instructions (usually 100–150mm).
  3. Fit foil-faced PIR or insulated sandwich panels — for roofs, use 50–75mm PIR panels fixed to purlins with manufacturer-recommended screws and sealant; for walls, use 40–75mm panels behind cladding where space allows.
  4. Provide balanced ventilation — aim for continuous airflow: eaves vent intake plus ridge or roof vents. For active workshops, install a small 150–250mm extraction fan rated 200–400m³/hr on a timed or humidistat control.
  5. Add internal lining where needed — plasterboard creates a conditioned space; if you use plasterboard, ensure a vapour barrier strategy is consistent with the insulation product used (follow manufacturer instructions).

Product recommendations (practical picks):

  • PIR foil-backed panels (50mm) for roofs — good R-value per thickness and durable in humid cycles.
  • Closed-cell spray foam only when professionally applied — creates an air-tight layer but requires qualified applicators in Victoria due to VOC and fire requirements.
  • Whirlybird ridge vents for passive extraction — low maintenance, no power required.
  • Humidistat-controlled inline fans for workshops with frequent moisture or chemical use.

Further reading: For in-depth ventilation product choices and performance comparisons, consult our best roof vents guide and the roof air vents and shed ventilation systems buying guide.

Practical Melbourne tip: In inner and bayside suburbs, salt-laden air can increase corrosion risk—specify Colorbond coastal-grade steel and use stainless or hot-dipped galvanised fixings for external flashings per manufacturer guidance.

Transition: With condensation and insulation addressed, maintain your shed correctly to preserve life and warranty.

Maintenance Tips and Longevity of Windspray Colorbond Sheds

  • Regular gutter and downpipe clearing — clean twice yearly and after storms to prevent ponding that accelerates corrosion.
  • Wash panels annually — rinse with fresh water to remove salts and pollutants; use a soft brush and mild detergent for stubborn stains.
  • Inspect seals and flashings — check silicone and EPDM washers yearly; replace torn seals within 12 months to maintain water integrity.
  • Touch-up paint and cut-edge protection — apply manufacturer-recommended touch-up paint to cut edges within 30 days of installation to reduce corrosion risk.
  • Check for leaks after heavy storms — document and repair any water entry points promptly to prevent timber rot or mould.
  • Warranty and documentation — keep the Colorbond product codes and supplier invoice; register warranties as required by the manufacturer.
  • Pest resistance — Colorbond steel is pest-proof, but doors and skirting may let rodents in—fit door seals and raised thresholds where needed.
  • Periodic fastener checks — inspect screws and washers; replace corroded fasteners with stainless options to maintain integrity.

Transition: Final recommendations and when to hire a pro follow.

Conclusion and Recommendations

Windspray Colorbond sheds offer a durable, low-maintenance option for Melbourne homeowners and small businesses. Choose standard kits for cost-efficiency, invest in a reinforced slab for workshops, and prioritise roof and wall insulation combined with balanced ventilation to control condensation. For permit queries, refer to the Victorian Building Authority and local council resources; for manufacturer performance data consult Colorbond technical manuals. If site conditions include slopes, coastal exposure, or complex council requirements, hire a licensed builder or structural engineer.

Ready to proceed? Get three quotes, confirm permit requirements with your council, and begin with a clear scope: chosen size, foundation type, ventilation and insulation choices. For insulation specifics see our pillar resource: Shed Insulation Guide with Panels and Wall Insulation Tips.

Call to action: Specify your shed footprint and request a site visit from two local installers in Melbourne to compare site-specific foundation recommendations and warranties.

Table of Contents

Keep Reading

Guidance and destination inspiration to help you explore more places without the stress of overthinking every booking decision.

Garden Shed Greenhouse Guide for Efficient Shed and Greenhouse

Garden Shed Greenhouse Guide for Efficient Shed and Greenhouse

Garden shed greenhouse conversion guide: step-by-step planning, insulation, ventilation and condensation control for Melbourne gardens. Start today.

Roof Air Vents and Shed Ventilation Systems Buying Guide

Roof Air Vents and Shed Ventilation Systems Buying Guide

Roof air vents buying guide for Melbourne sheds. Compare shed roof vent types, calculate vent area, and install garden shed air vents step-by-step. Read now.

Roof Ventilation Installation Guide and Roof Flume Options

Roof Ventilation Installation Guide and Roof Flume Options

Roof ventilation installation guide with step-by-step roof flume options, timings and quantities. Practical how-to for shed owners — start today.
